Activity Network Diagram in Six Sigma: A Complete Guide

An Activity Network Diagram (AND) is an essential tool for planning, scheduling, and controlling projects. In Six Sigma, it supports teams in managing complex improvement initiatives. It offers a visual roadmap to track sequences, durations, and dependencies.

By mapping activities, you can spot risks, optimize timelines, and improve resource allocation. ANDs are especially helpful in DMAIC projects, where understanding task relationships is key.

This guide explains how Activity Network Diagrams work and how to apply them in Six Sigma projects.

What Is an Activity Network Diagram?

An Activity Network Diagram shows the sequence of tasks in a project. Each task is displayed as a node or arrow, depending on the diagram style. Arrows indicate dependencies between activities.

Activity Network Diagram examples: AOA vs AON

The diagram shows how tasks connect. It also shows which activities can run in parallel and which ones must wait.

In Six Sigma, this visibility improves planning and execution. You can focus efforts where they matter most.

Other names for this tool include:

  • Project Network Diagram
  • Activity-On-Arrow (AOA) Diagram
  • Activity-On-Node (AON) Diagram
  • Critical Path Diagram

Why Use Activity Network Diagrams in Six Sigma?

Six Sigma aims to reduce variation and improve process quality. To achieve this, projects must follow a structured path. Activity Network Diagrams help teams deliver consistent results.

They are especially useful for:

BenefitExplanation
Sequencing tasksShows which activities must occur first
Estimating timeHelps predict project duration accurately
Finding critical tasksIdentifies tasks that can’t be delayed
Reducing project delaysHelps manage float and avoid bottlenecks
Coordinating cross-functional workMakes interdepartmental tasks clear
Improving team communicationOffers visual clarity on who does what and when

Six Sigma projects often involve multiple stakeholders. A clear diagram keeps everyone on the same page.

Key Elements of an Activity Network Diagram

To build an effective diagram, you need to understand its components.

ElementDescription
ActivityA task or work item that takes time and resources
NodeA visual representation of an activity or milestone
ArrowShows the direction of task flow and dependencies
Start EventFirst task in the process or project
Finish EventLast task or goal to be completed
DurationThe amount of time an activity takes
DependencyThe relationship between activities

Each of these parts connects to form a visual project roadmap.

Two Main Types: AON vs AOA

There are two major types of Activity Network Diagrams:

TypeDescriptionUse Case
Activity-On-Arrow (AOA)Uses arrows to represent activities; nodes are events (start or end of an activity)Used in traditional project scheduling
Activity-On-Node (AON)Uses boxes (nodes) to show activities; arrows represent dependenciesCommon in modern Six Sigma projects

Most Six Sigma professionals use AON diagrams. They are simpler to read, easier to create, and more flexible.

Building an Activity Network Diagram: Step-by-Step

Let’s walk through the process of creating one. This example uses the AON format.

Step 1: List All Project Activities

Start with a Work Breakdown Structure (WBS). Break the project into individual tasks.

Example:

Activity IDTask DescriptionEstimated Duration (Days)
ADefine the project scope2
BIdentify stakeholders1
CCollect baseline data3
DAnalyze current process4
EDevelop improvement plan3
FImplement improvement5
GValidate and document results2

Step 2: Identify Dependencies

Determine which activities depend on others.

ActivityMust Follow
ANone
BA
CA
DC
ED
FE
GF

Step 3: Draw the Diagram

Use rectangles for activities. Draw arrows between them based on dependencies.

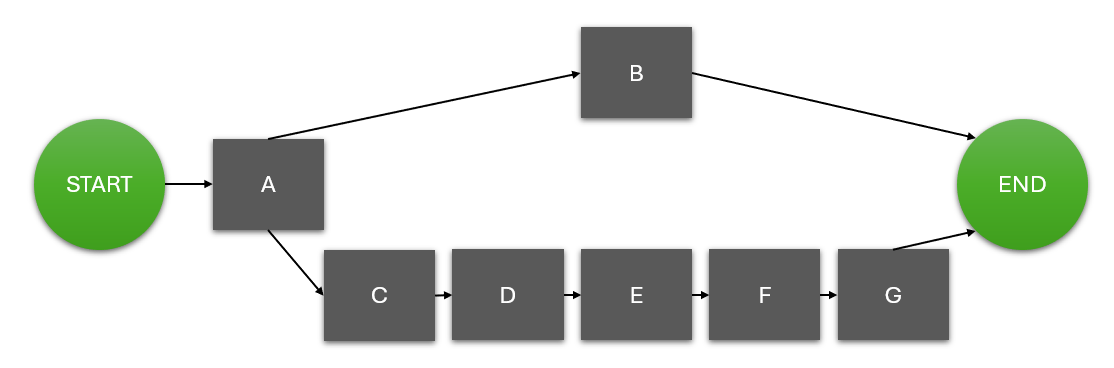

Activity Network Diagram example

This visual shows the flow of tasks and where parallel work can occur.

Step 4: Add Durations

Mark the estimated duration on each activity.

Activity Network Diagram example

Step 5: Identify the Critical Path

The critical path is the longest route from start to finish. It determines the shortest possible project duration.

In this example:

  • Path 1: A → B = 2 + 1 = 3 days
  • Path 2: A → C → D → E → F → G = 2 + 3 + 4 + 3 + 5 + 2 = 19 days

The second path is the critical path. Any delay here delays the entire project.

Example: Activity Network Diagram for a DMAIC Project

Let’s look at an example of an activity network diagram in a real Six Sigma context. This project aims to reduce the defect rate in a welding process.

TaskDurationPredecessor(s)
A: Define problem1 day—
B: Measure defect baseline3 daysA
C: Analyze root causes4 daysB
D: Test solutions2 daysC
E: Train operators2 daysD
F: Implement controls3 daysE
G: Final audit1 dayF

Critical Path: A → B → C → D → E → F → G = 16 days

Tasks outside this path may have float. But any delay along the critical path extends the project.

What Is the Critical Path Method (CPM)?

The Critical Path Method is a scheduling tool that uses activity network diagrams to calculate:

  • Earliest start time (ES)
  • Earliest finish time (EF)
  • Latest start time (LS)
  • Latest finish time (LF)
  • Slack or float

It helps identify which tasks require strict attention.

CPM Example

Suppose you have this data:

ActivityDurationPredecessor
A2 days—
B3 daysA
C4 daysA
D5 daysB, C

Two paths exist:

  • A → B → D = 2 + 3 + 5 = 10 days
  • A → C → D = 2 + 4 + 5 = 11 days

The second path is longer. It’s the critical path. Delays here will impact delivery.

Using Float to Manage Resources

Float is the amount of time a task can be delayed without affecting the project’s end date.

Knowing float helps managers:

  • Reassign underutilized team members
  • Focus resources on critical activities
  • Prevent schedule bottlenecks

You can calculate float using:

Float = LS – ES
or
Float = LF – EF

If float = 0, the activity is on the critical path.

Integrating ANDs in the DMAIC Framework

Activity Network Diagrams can support every phase of DMAIC:

DMAIC PhaseHow AND Helps
DefineClarifies scope and major milestones
MeasureSchedules data collection and validation efforts
AnalyzeStructures root cause analysis activities
ImproveAligns pilot testing, training, and implementation
ControlHelps plan audits, documentation, and monitoring reviews

Let’s go deeper.

Define Phase

Use an AND to lay out project kickoff activities. Include stakeholder alignment, charter approval, and initial risk assessments.

Measure Phase

Sequence the data collection plan. Make sure all variables are gathered before statistical analysis starts.

Analyze Phase

Use the diagram to schedule cause-and-effect mapping, hypothesis testing, and Pareto analysis.

Improve Phase

Coordinate pilot runs, improvement actions, and team training. Use the diagram to prevent overlapping efforts.

Control Phase

Plan follow-up audits and documentation efforts. Visualize timing for control charts and process monitoring.

Common Challenges and How to Avoid Them

Despite their strengths, activity network diagrams have pitfalls.

ChallengeSolution
Too many tasks in one diagramBreak the project into sub-projects
Incorrect task durationsUse data from past projects or consult subject matter experts
Missed dependenciesReview with stakeholders and cross-functional teams
Diagram becomes outdatedUpdate regularly as work progresses

Frequent reviews keep your diagram relevant and useful.

Software Tools to Create Activity Network Diagrams

You don’t have to draw diagrams by hand. Use software to save time and increase accuracy.

ToolBest ForKey Features
Microsoft ProjectEnterprise-level planningGantt charts, CPM, resource allocation
LucidchartQuick visual planningDrag-and-drop interface, real-time sharing
SmartDrawProcess documentationTemplates for Six Sigma and project diagrams
ExcelSimple, low-cost setupsCustom shapes and connectors
Primavera P6Large-scale industrial projectsAdvanced scheduling and cost control

Choose a tool that fits your team’s size, complexity, and budget.

Case Study: Improving Lead Time in Customer Support

A telecom company used Six Sigma to reduce support ticket lead times.

Project Goal

Cut average resolution time from 5 days to 2 days.

Tasks Included

  • Define issue and set baseline
  • Map customer complaint process
  • Collect data from CRM
  • Analyze root causes
  • Test automation tools
  • Train support agents
  • Implement workflow changes
  • Measure final outcomes

The team used an AON diagram to:

  • Spot redundant steps
  • Prioritize testing over manual solutions
  • Track rollout and training activities

They used the critical path to identify where delays would hit hardest. As a result, they cut resolution time to 1.8 days—a 64% improvement.

When to Use an Activity Network Diagram in Six Sigma

Use ANDs whenever you need to map task sequences and avoid delays.

Use CaseDMAIC PhaseWhy It Matters
Project planning and scope definitionDefineSets expectations early
Data collection sequenceMeasureEnsures data is ready before analysis
Structuring experiments or trialsAnalyzePrevents overlapping root cause tests
Coordinating rollout of improvementsImproveKeeps teams on schedule
Audit and documentation planningControlHelps maintain process improvements over time

Conclusion

Activity Network Diagrams are a powerful planning tool in Six Sigma. They show the big picture while highlighting critical paths, slack time, and dependencies. This insight improves team coordination, minimizes delays, and ensures projects hit their goals.

Whether you’re launching a new process, fixing a bottleneck, or rolling out training, ANDs give your project structure. They bring clarity to complexity and help you lead with confidence.

Master this tool and add precision to every project phase.
